A solution to a project management problem involving the determination of a precedence diagram, cycle time, minimum number of workstations, task assignments, and resource utilization. The problem includes task dependencies, task times, and workstation capacities.
Typology: Lab Reports
1 / 3
This page cannot be seen from the preview
Don't miss anything!

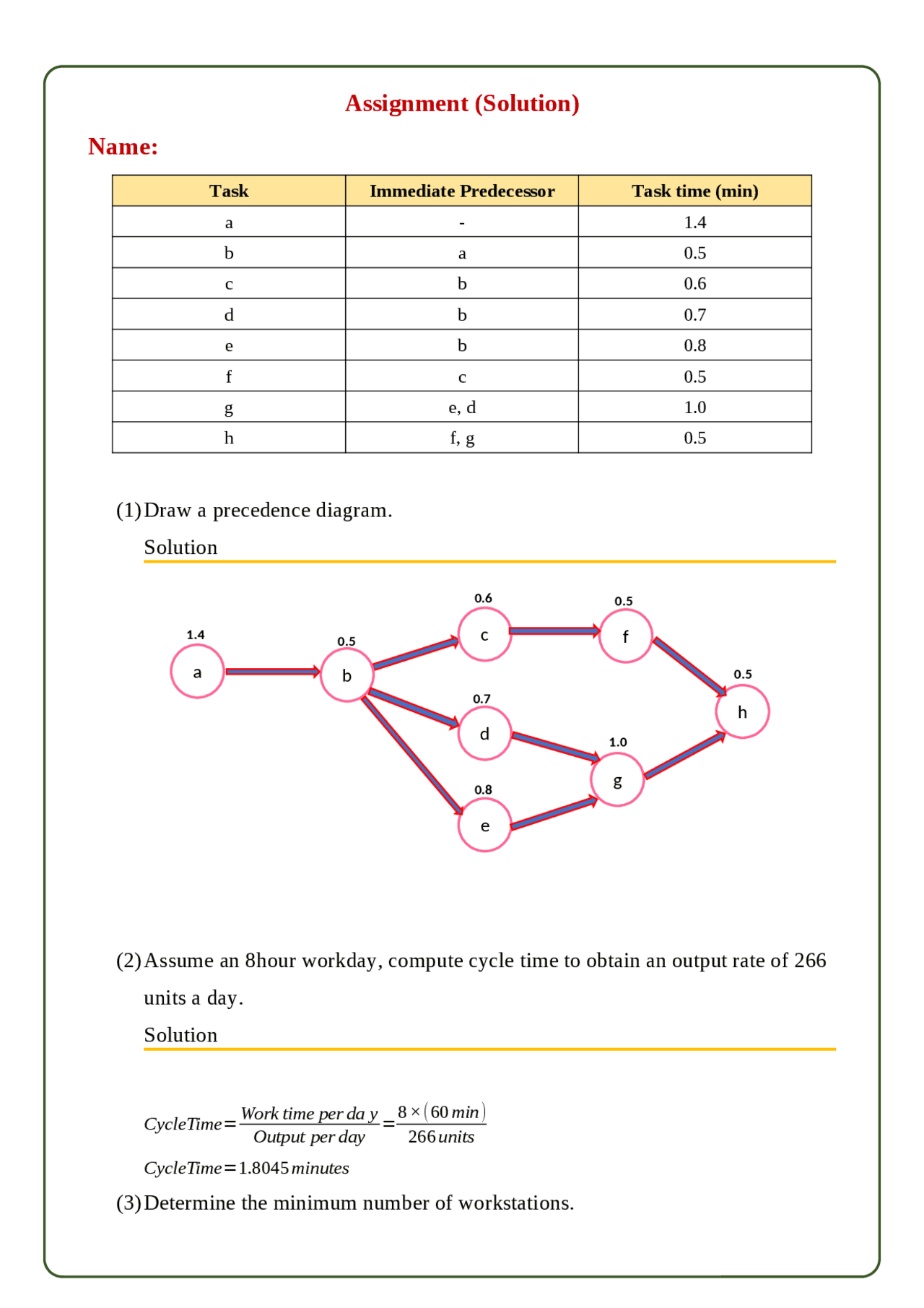

a (^) b c d e f g h 1.4 (^) **0.
0.**
Task Immediate Predecessor Task time (min) a - 1. b a 0. c b 0. d b 0. e b 0. f c 0. g e, d 1. h f, g 0.
CycleTime = Work time per da y Output per day
8 × ( 60 min ) 266 units CycleTime =1.8045 minutes
cycletime N =
∴ Minimum Number of Workstations =3.325 ≈ 4
Table 1 : Terms of Greatest Positional Weight Task Task Time in minutes Number of Following Tasks Positional Weight (Highest to Lowest)
