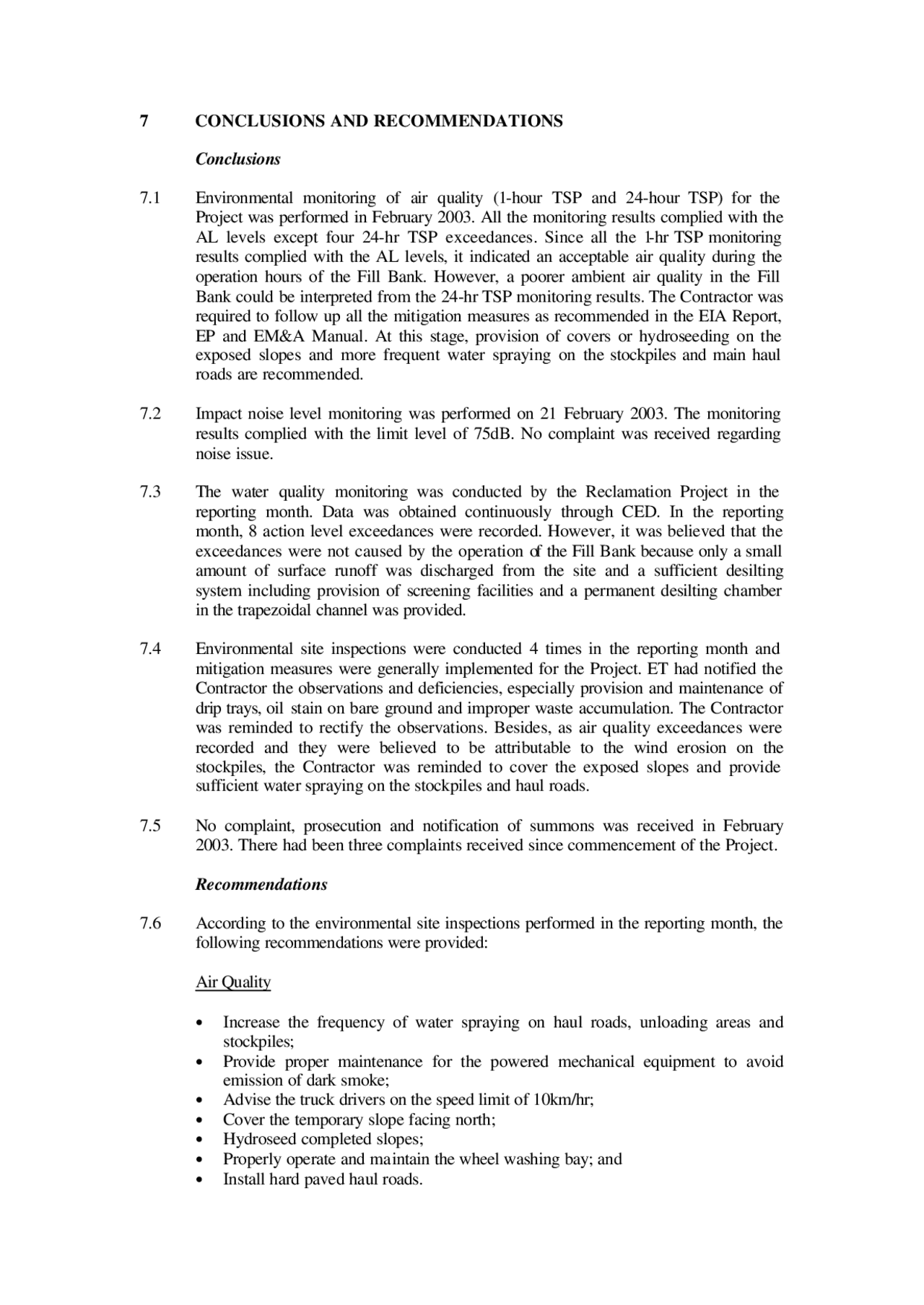

7 CONCLUSIONS AND RECOMMENDATIONS
Conclusions
7.1 Environmental monitoring of air quality (1-hour TSP and 24-hour TSP) for the
Project was performed in February 2003. All the monitoring results complied with the
AL levels except four 24-hr TSP exceedances. Since all the 1-hr TSP monitoring
results complied with the AL levels, it indicated an acceptable air quality during the
operation hours of the Fill Bank. However, a poorer ambient air quality in the Fill
Bank could be interpreted from the 24-hr TSP monitoring results. The Contractor was
required to follow up all the mitigation measures as recommended in the EIA Report,
EP and EM&A Manual. At this stage, provision of covers or hydroseeding on the
exposed slopes and more frequent water spraying on the stockpiles and main haul
roads are recommended.
7.2 Impact noise level monitoring was performed on 21 February 2003. The monitoring
results complied with the limit level of 75dB. No complaint was received regarding
noise issue.
7.3 The water quality monitoring was conducted by the Reclamation Project in the
reporting month. Data was obtained continuously through CED. In the reporting
month, 8 action level exceedances were recorded. However, it was believed that the
exceedances were not caused by the operation of the Fill Bank because only a small
amount of surface runoff was discharged from the site and a sufficient desilting
system including provision of screening facilities and a permanent desilting chamber
in the trapezoidal channel was provided.
7.4 Environmental site inspections were conducted 4 times in the reporting month and
mitigation measures were generally implemented for the Project. ET had notified the
Contractor the observations and deficiencies, especially provision and maintenance of
drip trays, oil stain on bare ground and improper waste accumulation. The Contractor
was reminded to rectify the observations. Besides, as air quality exceedances were
recorded and they were believed to be attributable to the wind erosion on the
stockpiles, the Contractor was reminded to cover the exposed slopes and provide
sufficient water spraying on the stockpiles and haul roads.
7.5 No complaint, prosecution and notification of summons was received in February
2003. There had been three complaints received since commencement of the Project.
Recommendations
7.6 According to the environmental site inspections performed in the reporting month, the
following recommendations were provided:
Air Quality
Increase the frequency of water spraying on haul roads, unloading areas and
stockpiles;
Provide proper maintenance for the powered mechanical equipment to avoid
emission of dark smoke;
Advise the truck drivers on the speed limit of 10km/hr;
Cover the temporary slope facing north;
Hydroseed completed slopes;
Properly operate and maintain the wheel washing bay; and
Install hard paved haul roads.
pf2

Partial preview of the text

Download Environmental Monitoring and Recommendations for a Fill Bank Project and more Slides Environmental Science in PDF only on Docsity!

7 CONCLUSIONS AND RECOMMENDATIONS

Conclusions

7.1 Environmental monitoring of air quality (1-hour TSP and 24-hour TSP) for the Project was performed in February 2003. All the monitoring results complied with the AL levels except four 24-hr TSP exceedances. Since all the 1-hr TSP monitoring results complied with the AL levels, it indicated an acceptable air quality during the operation hours of the Fill Bank. However, a poorer ambient air quality in the Fill Bank could be interpreted from the 24-hr TSP monitoring results. The Contractor was required to follow up all the mitigation measures as recommended in the EIA Report, EP and EM&A Manual. At this stage, provision of covers or hydroseeding on the exposed slopes and more frequent water spraying on the stockpiles and main haul roads are recommended.

7.2 Impact noise level monitoring was performed on 21 February 2003. The monitoring results complied with the limit level of 75dB. No complaint was received regarding noise issue.

7.3 The water quality monitoring was conducted by the Reclamation Project in the reporting month. Data was obtained continuously through CED. In the reporting month, 8 action level exceedances were recorded. However, it was believed that the exceedances were not caused by the operation of the Fill Bank because only a small amount of surface runoff was discharged from the site and a sufficient desilting system including provision of screening facilities and a permanent desilting chamber in the trapezoidal channel was provided.

7.4 Environmental site inspections were conducted 4 times in the reporting month and mitigation measures were generally implemented for the Project. ET had notified the Contractor the observations and deficiencies, especially provision and maintenance of drip trays, oil stain on bare ground and improper waste accumulation. The Contractor was reminded to rectify the observations. Besides, as air quality exceedances were recorded and they were believed to be attributable to the wind erosion on the stockpiles, the Contractor was reminded to cover the exposed slopes and provide sufficient water spraying on the stockpiles and haul roads.

7.5 No complaint, prosecution and notification of summons was received in February

  1. There had been three complaints received since commencement of the Project.

Recommendations

7.6 According to the environmental site inspections performed in the reporting month, the following recommendations were provided:

Air Quality

  • Increase the frequency of water spraying on haul roads, unloading areas and stockpiles;
  • Provide proper maintenance for the powered mechanical equipment to avoid emission of dark smoke;
  • Advise the truck drivers on the speed limit of 10km/hr;
  • Cover the temporary slope facing north;
  • Hydroseed completed slopes;
  • Properly operate and maintain the wheel washing bay; and
  • Install hard paved haul roads.

Construction Noise

  • Ensure air compressor and hand held breaker be provided with noise label.

Water Quality

  • Reuse wastewater after proper treatment;
  • Remove stagnant water or provide pesticide; and
  • Ensure the cleanliness of the trapezoidal and all other surface channels.

Chemical and Waste Management

  • Remove waste materials from site to avoid accumulation regularly;
  • Provide chemical waste storage area in accordance with the chemical waste producer registration requirement;
  • Avoid waste accumulation, especially after completion of individual construction works;
  • Remove unwanted material in the existing stockpiles and avoid further dumping of such material;
  • Provide and maintain sufficient drip trays for diesel drums, chemical containers and diesel operated generator set; and
  • Avoid soil being contaminated during oil replacement and properly remove and store the contaminated soil, if any.

Landscape and Visual

  • Erect all the site hoardings/chaining fences in accordance with agreed design at proper location.
