The impact of stakeholder influence on project success through interviews with project managers and regional project managers. It highlights the importance of stakeholder communication, education, and management in ensuring project success, particularly in public sector projects. Key areas of impact include reporting, project performance, and organizational challenges.

Typology: Lecture notes

2021/2022

Uploaded on 09/27/2022

linden
linden 🇬🇧

4.4

(8)

217 documents

1 / 10

Toggle sidebar

This page cannot be seen from the preview

Don't miss anything!

bg1

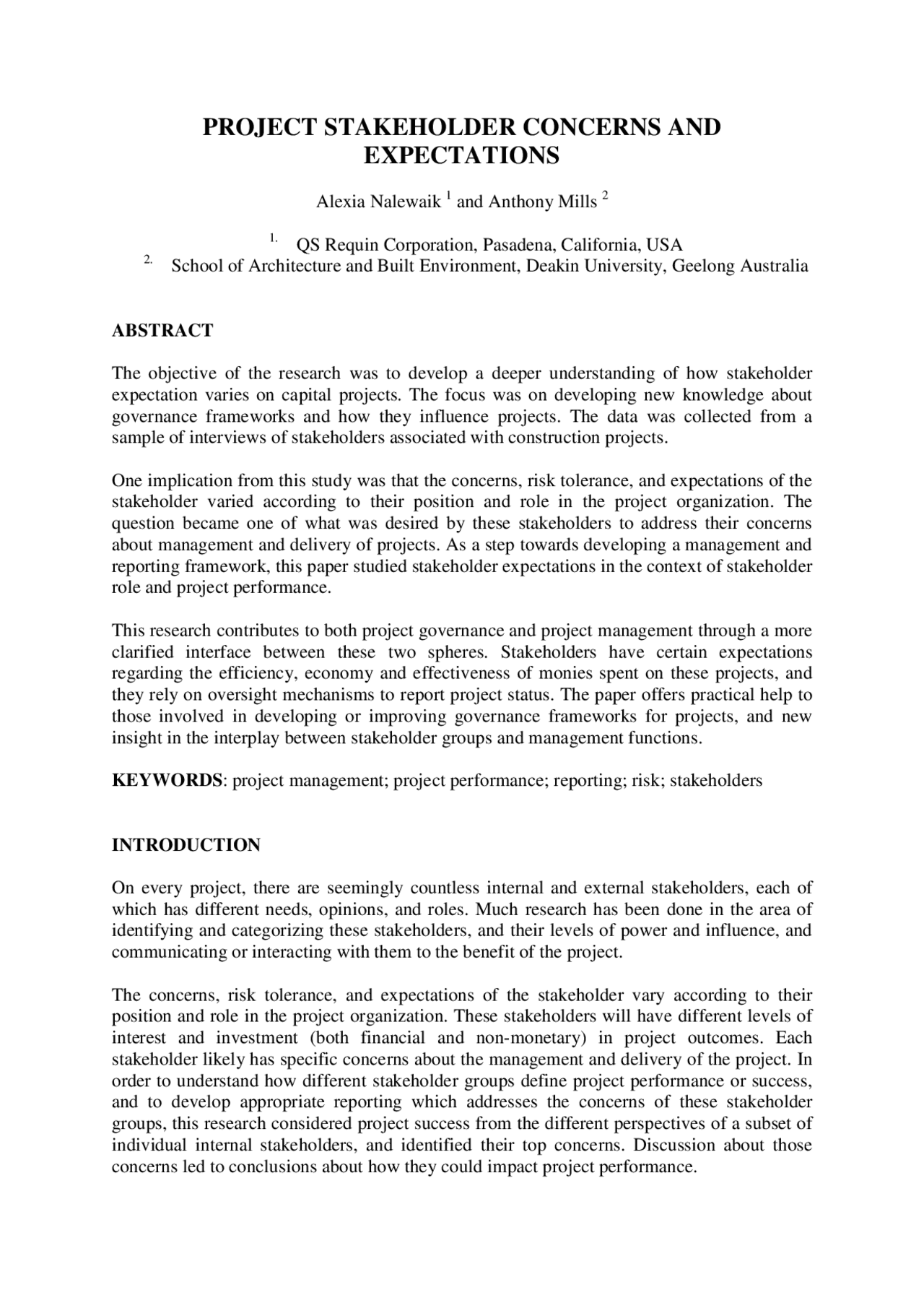

PROJECT STAKEHOLDER CONCERNS AND
EXPECTATIONS
Alexia Nalewaik 1 and Anthony Mills 2
1. QS Requin Corporation, Pasadena, California, USA
2. School of Architecture and Built Environment, Deakin University, Geelong Australia
ABSTRACT
The objective of the research was to develop a deeper understanding of how stakeholder
expectation varies on capital projects. The focus was on developing new knowledge about
governance frameworks and how they influence projects. The data was collected from a
sample of interviews of stakeholders associated with construction projects.
One implication from this study was that the concerns, risk tolerance, and expectations of the
stakeholder varied according to their position and role in the project organization. The
question became one of what was desired by these stakeholders to address their concerns
about management and delivery of projects. As a step towards developing a management and
reporting framework, this paper studied stakeholder expectations in the context of stakeholder
role and project performance.
This research contributes to both project governance and project management through a more
clarified interface between these two spheres. Stakeholders have certain expectations
regarding the efficiency, economy and effectiveness of monies spent on these projects, and
they rely on oversight mechanisms to report project status. The paper offers practical help to
those involved in developing or improving governance frameworks for projects, and new
insight in the interplay between stakeholder groups and management functions.
KEYWORDS: project management; project performance; reporting; risk; stakeholders
INTRODUCTION
On every project, there are seemingly countless internal and external stakeholders, each of
which has different needs, opinions, and roles. Much research has been done in the area of
identifying and categorizing these stakeholders, and their levels of power and influence, and
communicating or interacting with them to the benefit of the project.
The concerns, risk tolerance, and expectations of the stakeholder vary according to their
position and role in the project organization. These stakeholders will have different levels of
interest and investment (both financial and non-monetary) in project outcomes. Each
stakeholder likely has specific concerns about the management and delivery of the project. In
order to understand how different stakeholder groups define project performance or success,
and to develop appropriate reporting which addresses the concerns of these stakeholder
groups, this research considered project success from the different perspectives of a subset of
individual internal stakeholders, and identified their top concerns. Discussion about those
concerns led to conclusions about how they could impact project performance.
pf3
pf4
pf5
pf8
pf9
pfa

Partial preview of the text

Download Understanding Stakeholder Influence on Project Success: A Research Perspective and more Lecture notes Construction in PDF only on Docsity!

PROJECT STAKEHOLDER CONCERNS AND

EXPECTATIONS

Alexia Nalewaik 1 and Anthony Mills 2

  1. (^) QS Requin Corporation, Pasadena, California, USA
  2. (^) School of Architecture and Built Environment, Deakin University, Geelong Australia

ABSTRACT

The objective of the research was to develop a deeper understanding of how stakeholder expectation varies on capital projects. The focus was on developing new knowledge about governance frameworks and how they influence projects. The data was collected from a sample of interviews of stakeholders associated with construction projects.

One implication from this study was that the concerns, risk tolerance, and expectations of the stakeholder varied according to their position and role in the project organization. The question became one of what was desired by these stakeholders to address their concerns about management and delivery of projects. As a step towards developing a management and reporting framework, this paper studied stakeholder expectations in the context of stakeholder role and project performance.

This research contributes to both project governance and project management through a more clarified interface between these two spheres. Stakeholders have certain expectations regarding the efficiency, economy and effectiveness of monies spent on these projects, and they rely on oversight mechanisms to report project status. The paper offers practical help to those involved in developing or improving governance frameworks for projects, and new insight in the interplay between stakeholder groups and management functions.

KEYWORDS : project management; project performance; reporting; risk; stakeholders

INTRODUCTION

On every project, there are seemingly countless internal and external stakeholders, each of which has different needs, opinions, and roles. Much research has been done in the area of identifying and categorizing these stakeholders, and their levels of power and influence, and communicating or interacting with them to the benefit of the project.

The concerns, risk tolerance, and expectations of the stakeholder vary according to their position and role in the project organization. These stakeholders will have different levels of interest and investment (both financial and non-monetary) in project outcomes. Each stakeholder likely has specific concerns about the management and delivery of the project. In order to understand how different stakeholder groups define project performance or success, and to develop appropriate reporting which addresses the concerns of these stakeholder groups, this research considered project success from the different perspectives of a subset of individual internal stakeholders, and identified their top concerns. Discussion about those concerns led to conclusions about how they could impact project performance.

LITERATURE REVIEW

There are many different approaches to defining stakeholders. Some place considerable emphasis on fiduciary or contractual obligations (Orts and Strudler, 2002). Others, such as (Freeman, 1984), consider a stakeholder to be “… any group or individual who can affect or is affected by the achievement of the organization’s objectives.” For the purposes of this paper, we adopt the definition by (Bourne and Walker, 2005), in which stakeholders are “… individuals or groups who have an interest or some aspect of rights or ownership in the project, and can contribute to, or be impacted by, the outcomes of the project.”

The list of stakeholders on a project can be substantial, including: employees, contractors, suppliers, governing bodies, financiers, clients and end users, the general public, unions, special interest groups, and even future generations. Some of these stakeholder groups will have more influence than others, due to the nature of their relationship to the project and Owner. The list of stakeholders with which the project team invests time and energy is thus often narrowed down to those who have the greatest ability to positively or negatively impact the project. Literature from the Project Management Institute (PMI, 2008) indicates that project stakeholders typically comprise a project manager, the customer / end user, performing organizations (the firms whose employees directly participate in realizing the project), project team members, the project management team, project sponsor, other people of influence, and the project management organization (PMO).

The most popular approach to managing stakeholders is to categorize them into several groups depending on their relative position in the project, level of involvement in the project, or legal relations between them and the project. Project-specific stakeholders may include the project sponsor, end users, client (Owner), and core project team members, together with community, ‘shadow’ team members (people who have informal relations with the project), and external groups (Walker 2003).

However, stakeholders may also be defined in a more granular fashion. This particular research focuses on four subsets of internal stakeholders. Such stakeholders have an official or contractual relationship with the project or organization (Winch, 2004) or are directly involved in decision-making processes for the project or organization (Atkin and Skitmore, 2008). (Rowlinson and Cheung, 2008) further divide stakeholders into classes of upstream stakeholders (customers and end users), downstream stakeholders (contractors and suppliers), external stakeholders (independent concerned parties and general public), invisible stakeholders, and project stakeholders (champion and delivery team). (Moodley et al, 2008) divide stakeholders into explicit stakeholders (owners and others with direct financial interests), implicit stakeholders (end users), implicitly recognized stakeholders (government and community), and other unknown stakeholders.

Because stakeholders can affect project outcomes, the definition of project success needs to be understood from the perspectives of different stakeholder groups, and should also consider the varying levels of interest and investment in project outcomes by different stakeholders (Newcombe, 2003). The definition of project success may vary from stakeholder to stakeholder, and may even conflict; depending on which stakeholder perspective is considered, a project may conceivably be both a success and a failure at the same time (Nalewaik, 2011). The organization must therefore adopt a stakeholder perspective when focusing on project outcomes (Nalewaik, 2011). (Walker & Bourne, 2005) identified

Facilities Management interviews included facilities managers, who were sometimes included during the project planning process and who would ultimately be responsible for maintaining the facilities along with their facilities and maintenance staff. These people were employed by and accountable to Owner Administration.

Project Management interviews included project managers and regional project managers, who were responsible for the oversight and delivery of the projects along with their project management staff. The project management group was also tasked with generating periodic (often monthly) project status reports. These individuals were contracted to and thus accountable to Owner Administration (and Facilities Management), and all their implied internal and external stakeholders.

Construction Management interviews included construction managers, who were responsible for the timely and satisfactory construction of the projects along with their construction management staff. Field data from construction contribute to project status and risk reports. These people were directly accountable to Project Management, and ultimately accountable to both Owner Administration and Facilities Management, and all their implied internal and external stakeholders. Depending on the Owner entity, Construction Management was contracted to either Project Management or Owner Administration.

The next section of the paper presents the results of the interviews, and offers an explanation of how stakeholders can impact both status reports and definitions of project success.

RESULTS

The top three concerns for each stakeholder group are shown in Table 1, below. Where there is a statistical tie, several results are listed.

Table 1: Top three stakeholder concerns

Top Concerns

Owner Administration

Facilities Management

Project Management

Construction Management 1 -Communication^ -Staffing (Financial)

-Communication -Teamwork with other stakeholders

-Communication

2 -Project cost -Communication -Staffing (Turnover)

-Policies & procedures (timeliness / bureaucracy) 3 -Managing expectations -Teamwork with other stakeholders -Staffing (Financial)

-Policies & procedures (standards)

-Project cost -Contractor issues -Managing expectations -Staffing (Turnover)

The interviews provided deeper understanding of dynamics within the stakeholder matrix. Where both Owner Administration and Construction Management expressed concerns about managing expectations, one can see reflected in the answer the relationship between the two stakeholder groups. A similar push & pull was shown in the “teamwork” concerns stated by Owner Administration and Project Management.

In addition, the interviews provided context and clarification regarding the responses. At first glance, the “staffing” concern identified by three stakeholder groups appeared to reflect a universal issue. However, further explanation by the interviewees made it clear the concern was not exactly the same. For Facilities Management and Owner Administration, the Staffing (Financial) concern was financial; public funding was provided for design and construction of the new facilities, but no additional funding was provided for hiring additional staff to maintain those new facilities. In contrast, the Staffing (Turnover) concerns by Project Management and Construction Management were related to changes on the project team; when staff accepted jobs elsewhere, institutional knowledge was lost, and qualified replacements were difficult to find.

Other stakeholder concerns, which did not rank in the top three for any of the four stakeholder groups, included:

 Trust  Project planning  Conflicting priorities & urgency  Politics  Safety  Documentation  Project schedule  Scope creep  Satisfying the client / stakeholders  Too many meetings  Accuracy in reporting  Change management  Chain of command

The next section of the paper address the issues associated with each of the stakeholder groups, and their potential impact on both project performance and reporting.

DISCUSSION

Scholars and industry practitioners alike have for many decades been attempting to investigate and identify the key factors that lead to project success. Capital projects attract a large number of individuals, organizations, and companies who interact with each other and influence the project in many ways. Once these stakeholders have been identified, measures of effectiveness can be developed against which their impact can be evaluated, governance developed to address the reporting and approvals structures, and mitigation put in place for potential conflicts between stakeholders. The topics of reporting and project performance, below, illustrate two key areas likely to be impacted by stakeholder diversity.

Construction Management identified timeliness / bureaucracy as a primary concern, which reflected the various project management policies & procedures to be followed and approvals required in order for the project to progress. Some of those requirements are typically regulatory or statutory, but the remainder of the project management processes are often created by the project management organization (PMO). Policies and procedures are often brought to a project or program by the PMO, from other projects where they were utilized, with various inherent challenges. The processes might not have been adapted to accurately reflect the client organization, or might be overly prescriptive in their effort to manage a large and complicated capital program. Further insight was provided during the interviews – the construction management teams had two specific issues with policies and procedures. Firstly, the processes were perceived to be burdensome. Secondly, auditors discovered the processes were often not being followed, which was a symptom of both the burden and the lack of fit to the client organization. Both these issues were reflected in the concern about policies and procedures. With a mandate to complete projects on time and on budget, Construction Management was especially focused on streamlining processes and minimizing the number of procedural requirements in order to deliver the projects. To this end, timeliness and bureaucracy could impact project performance and thus project success.

The other top Construction Management concern was the issue of Contractor performance, which is a typical challenge in a public sector low-bid environment. This risk to project performance is very well known in the industry, and well documented and discussed in both research and practice.

For both Facilities Management and Owner Administration, the Staffing (Financial) concern was critical. Because public funding was provided for design and construction of the new facilities, but no additional funding was provided for hiring additional staff to maintain those new facilities, the useful life of the buildings and infrastructure would be shorter than expected. Indeed, this phenomenon has been well documented on publicly funded projects in California, and is a considerable cause for concern. We are reminded that definitions of project success are not limited to just the time of building receipt, but through the entire lifecycle of the building.

As for Project Management and Construction Management, staffing issues related to turnover on the project team could also impact project success. When staff left the projects due to having accepted jobs elsewhere, valuable institutional and project knowledge was lost, and qualified replacements were difficult to find. During the time period represented by the sample population and interviews, there was considerable investment in public projects and thus much competition for and ‘poaching’ of project staff, resulting in seemingly nonstop turnover on project teams. The impact on projects could not be readily quantified, but continued to be felt on project teams even years after the fact, in terms of finding documentation, maintaining relationships with both internal and external stakeholders, and understanding the history and context behind decision-making.

Other lower-scoring concerns pointed to organizational challenges within the project team and Owner, which could conceivably impact project success. These included project planning (the involvement of end-user stakeholders in the process), conflicting priorities between stakeholders, differing levels of urgency by stakeholders, the politics and stakeholder relationships inherent in public sector projects, difficulties in satisfying a diverse and ever- changing stakeholder population, management of change, and chain-of-command challenges

which reflected often visceral reactions to the very structure of the stakeholder matrix. Many of these could easily be considered as subsets of the “managing expectations” and “teamwork” concerns discussed earlier.

Each of the above elements can be seen to relate to concepts of project performance and success, and thus each needs to be addressed satisfactorily in order to deliver the stakeholder’s vision of the project.

Project reporting

As can be seen in this research, communication was identified by all four stakeholder groups as a concern. A communication plan can be developed, specific to each stakeholder group, to address some of these issues.

We note that much of the necessary project communication is done through reporting, in addition to meetings, phone calls, and emails. However, the credibility and usefulness of reporting depends heavily on the report’s content, distribution, comprehension, and more (US EPA, 2007). Principles of inclusiveness address the issue of how relevant a report is to stakeholders. Discussions with and understanding of stakeholders should guide reporting, to endure reports present relevant information that can be readily understood by the intended audiences. “Because the ‘relevance threshold’ is subjective, an organization’s assessment of material issues cannot be completed without consideration of stakeholders’ expectations and interests” (US EPA, 2007). Project status reports may need to be tailored to specific stakeholder groups, meaning the project team may need to generate several different reports instead of just one which is one-size-fits-all. Reports should consider the materiality of available information, and the context in which it is presented such that the report may substantively influence stakeholder decision-making (US EPA, 2007). Due to the diverse nature of stakeholders, materiality may vary according to different stakeholder groups and serves to distinguish relevant information from the wide range of data which could be included in the report.

Project cost, along with project schedule, is often a key element in project reports. Indeed, the majority of project reports focus on the same type of project elements – cost, schedule, progress made, and incidents. Of the additional concerns identified in the research, several could be addressed and possibly mitigated through project reporting. Efforts at teamwork are not often visible after the fact; team activities and team-based decision-making, could be included in reports.

Constant communication and reporting can help the project team to address issues proactively and reduce the risk of a disconnect between the finished project and stakeholder expectations.

CONCLUSION

This research is a step toward understanding and analyzing the potential impact of stakeholders on public sector projects, and provides some insight to the levels of stakeholder influence on projects.

The top three stakeholder concerns identified in the research fall into two key categories: project success and communication. The discussion above offers practical suggestions for developing or improving governance frameworks for project performance (success), and

Beach, S, Brown, KA, & Keast, RL (2009). Staking a claim: the role of stakeholders in government, 13th International Research Society for Public Management Conference (IRSPM XIII) , Copenhagen Business School, Fredericksberg, Denmark, 6-8 April 2009, IRSPM.

Beach, Sandra and Keast, Robyn (2010). Governance networks and stakeholders : engaging through salience. 14th Annual Conference of the International Research Society for Public Management (IRSPMXIV) , 7‐9 April 2010, Bern, Switzerland.

Bourne, L.M. and Walker. D.H.T. (2004), Advancing Project Management in Learning Organizations, The Learning Organization , 11(3), 226-

Bourne, Lynda and Walker, Derek H.T., (2005). Visualising and mapping stakeholder influence, Management Decision , Vol. 43 Iss: 5 pp. 649 – 660

Cheung, Yan Ki Fiona; Zolin, Roxanne; Turner, J Rodney; Remington, Kaye (2010). Agree or disagree? Level of alignment between project manager and stakeholders on performance indicators. Proceedings of the 7th Annual Project Management Australia Conference , 23- August 2010, Brisbane Convention & Exhibition Centre, Australia.

Freeman, R. (1984). Strategic management: A Stakeholder Approach. Pitman Boston.

McElroy, B. and Mills, C. (2000), Managing Stakeholders, Gower Handbook of Project Management , ed. J. R. Turner and S. J. Simister, Gower Publishing Limited, 757-

Moodley, K., Smith, N., Preece, C.N. (2008). Stakeholder matrix for ethical relationships in the construction industry. Construction Management and Economics , 26 (6), 625-

Morledge, Roy (2010). Seeking Construction Success – approaches to reducing client disappointment. RICS COBRA 2010

Nalewaik, A. (2011). Stakeholder Expectations Regarding Public Project Oversight, IPMA 25th World Congress , Brisbane

Newcombe, R. (2003). From client to project stakeholders: a stakeholder mapping approach. Construction Management and Economics , 21(8), 841-848.

Orts, E.W. and Strudler, A. (2002). The Ethical and Environmental Limits of Stakeholder Theory. Business Ethics Quarterly , 12(2), 215-234.

Project Management Institute (2008). A Guide to the Project Management Book of Knowledge (PMBOK) , 4th ed., Newtown Square, PA, Project Management Institute.

Rowlinson, S. and Cheung, Y.K.F. (2008). Stakeholder management through empowerment: modelling project success. Construction Management and Economics , 26(6), 611-623.

United States Environmental Protection Agency (November, 2007). FRP Guide to Stakeholder Engagement

Walker, D. (2003), Implications of Human Capital Issues. Procurement Strategies: A Relationship- based Approach , ed. D. Walker and K. Hampson, Blackwell Science, 258-

Winch, G.M. (2004). Managing project stakeholders. Morris P. W. G. and Pinto J.K. (Eds.), The Wiley Guide to Managing Projects , John Wiley & Sons Inc., New Jersey.
