An overview of Stakeholder Analysis, a process used to identify and assess the interests and impact of stakeholders on a project. It includes information on how to carry out stakeholder analysis for small, medium, and major projects, as well as tools and strategies for stakeholder management.
Typology: Study notes
1 / 6
This page cannot be seen from the preview
Don't miss anything!




A stakeholder is any person, group or institution with an interest in the project. A stakeholder may not necessarily be involved/included in the decision making process. Stakeholders should be identified in terms of their roles not individual names.
Stakeholder Analysis is the identification of a project’s key stakeholders, an assessment of their interests and the ways in which these interests affect the project and its viability.
A stakeholder need not be directly affected by the project, for example one stakeholder could be a member of staff who will be using a new system that the project will implement, but the students who that member of staff provides a service to could also be stakeholders.
Stakeholder analysis results should be recorded carefully – the information can be very sensitive (e.g. a stakeholder may not like to be identified as a blocker). The audience for reporting results of stakeholder analysis must be considered very carefully if it is outside of the Project Board.
You should use workshops to carry out the information capture and analyses described below.
Stakeholder Analysis:
This toolkit presents a number of tools that you can use as part of stakeholder analysis and management. It is intended as a “pick list” – you do not necessarily have to use all of the tools described here. The bare minimum, however, is that you at least set aside time to identify who your stakeholders are, and how you are going to communicate with them.
Stakeholder analysis is not mandatory for Small projects, but it is advised so that you at least consider all those who will be directly affected and think about how the project might be affected by them.

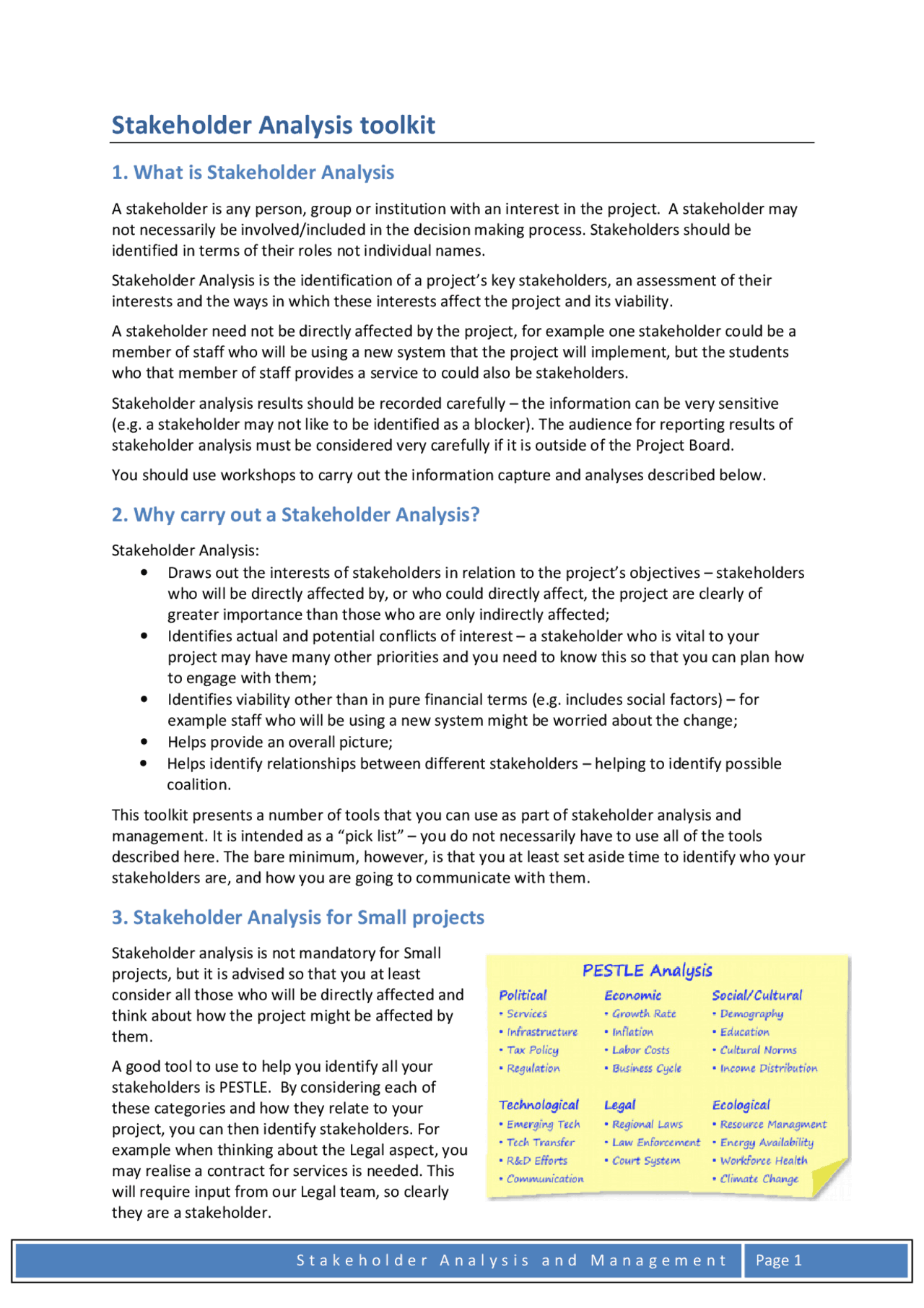

A good tool to use to help you identify all your stakeholders is PESTLE. By considering each of these categories and how they relate to your project, you can then identify stakeholders. For example when thinking about the Legal aspect, you may realise a contract for services is needed. This will require input from our Legal team, so clearly they are a stakeholder.
Once you have identified your stakeholders, the table below, which is an example of a simple stakeholder analysis, can be used as a template.
Stakeholder Stake in the project
Impact What do we need from them?
Perceived attitudes / risks
Stakeholder Management Strategy
Responsibility
Registrar Policy and process owner who determines institutional administrative policy and procedures
High Experienced staff to be involved in user group and user acceptance testing. Commitment to implementing change.
Lack of clarity about preferred approach. Views project team as too technically oriented.
Involvement in Project Steering Board, Regular updating meeting with project leader.
Project Manager
Faculty Managers
Manages School admin staff who will operate the new system at local level and academic staff who will indirectly input and directly extract data
Medium Commitment to implementing change.
Lack of interest in project.
Involvement in briefing sessions at quarterly School meetings.
Registrar and Project Sponsor
Admin Staff Will operate new system
High Contribute to system and process design and testing.
Concern about increased workload. Worried about what training they will receive.
Involvement in user groups.
Project Team
Having identified stakeholders and the management strategy for them, you should ensure your project plan includes those management activities.
Having carried out the initial analysis, this should be revisited regularly throughout the project both as a reminder that stakeholder positions can change, so the management strategy may have to alter, and that new stakeholders may be identified as the project progresses.
For Medium and Major projects it is vital to carry out a more detailed stakeholder analysis, not least because the success or failure of the project can depend on ensuring key stakeholders are kept informed and “on side”. A four-step process is ideal, but at least you should carry out the first two steps below.
4.1 Identify the stakeholders The same approach as noted above (3), using PESTLE can be used here. Similarly, a table – such as the one below – can be used to list them out and identify key aspects.
4.3 Identify Stakeholder Allegiance
The purpose of this step is to decide the extent to which each stakeholder (or stakeholder group) supports or opposes the project. The table below identifies the possible allegiances.
Assessment Definition How to Manage
Advocates • Only group driving the change or project
Followers • Have a low understanding of project aims and objectives
Indifferent • Individual or groups yet to take a definitive position on the project
Blockers Shows resistance to the project or its aims. Principally due to having a low understanding and low agreement. This can be driven by:
Opponents • Has high understanding but low agreement to the project
In our example, one would hope the Registrar, our project Sponsor, is an Advocate. The Faculty Managers could each occupy different positions so manager A might be a Follower and manager B a Blocker. Similarly the Admin staff in different faculties may hold different positions.
4.4 Create a Stakeholder Management Strategy
The strategy basically spells out where you want each stakeholder to “go” in terms of the project, and how you will manage them in order to get them there. The table on the next page illustrates this. The faces indicate where the stakeholder sits at present, and the arrows represent what movement you want to try and achieve for each stakeholder.
Stakeholder management is not a one-off process, but should be continual throughout the project, with regular cycling through all the stages to identify new stakeholders and changes in known ones.
Benefit Realisation Management is a process whereby the benefits of a project are identified and managed. It can also be used within Stakeholder Management, because you can look at what benefits each stakeholder might be most interested in, and this will help you adjust your communications accordingly. An example of a matrix that maps benefits against stakeholders appears below.
Stakeholder
Student Teaching staff QA staff Support staff Academic Board Programme Board Employers Benefits
22.Fewer units
Clearer information to students about deadlines
Greater clarity in organisational management
Bruce Levitan, Business Improvement Manager December 2009 (v1); March 2013 (v2); May 2014 (v3)
