A practice exam for pjm (pennsylvania-new jersey-maryland interconnection) generation dispatchers. It covers key concepts related to generator operation, synchronization, emergency procedures, voltage control, and market operations. The questions and answers are designed to test the knowledge required for dispatching and managing power generation resources within the pjm system. It includes topics such as exciter function, generator limits, synchronization requirements, geomagnetic disturbance procedures, terrorism advisory alerts, voltage warnings, and reporting requirements. It also covers emergency reducible generation, black start units, regulation, data exchange, reactive capability testing, and outage management. The practice exam is useful for those preparing for the pjm generation dispatcher exam or for anyone seeking to understand the complexities of power system operation and dispatch.

Typology: Exams

2024/2025

Available from 07/27/2025

aim-higher
aim-higher 🇺🇸

5

(2)

9.8K documents

1 / 7

Toggle sidebar

This page cannot be seen from the preview

Don't miss anything!

bg1

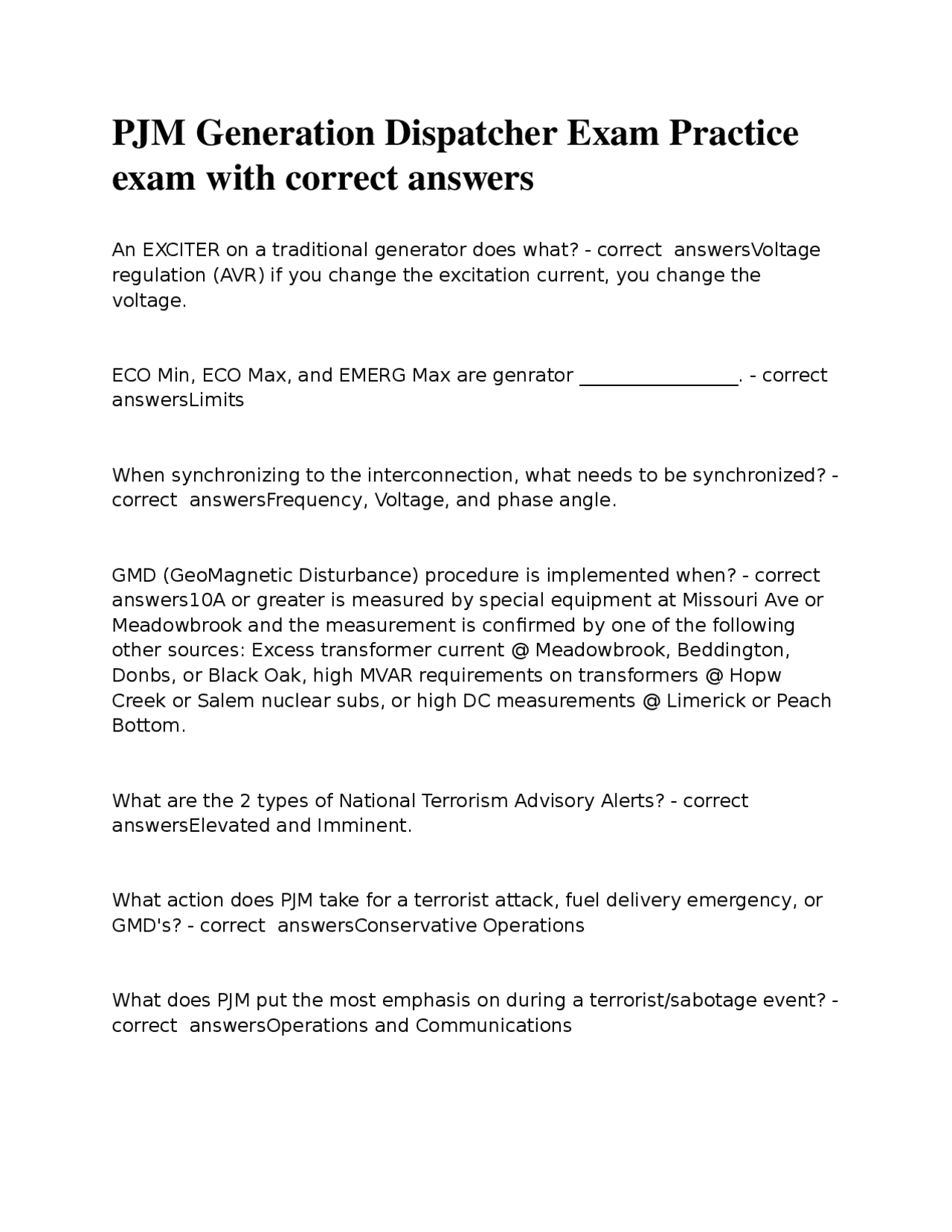

PJM Generation Dispatcher Exam Practice
exam with correct answers
An EXCITER on a traditional generator does what? - correct answersVoltage
regulation (AVR) if you change the excitation current, you change the
voltage.
ECO Min, ECO Max, and EMERG Max are genrator _________________. - correct
answersLimits
When synchronizing to the interconnection, what needs to be synchronized? -
correct answersFrequency, Voltage, and phase angle.
GMD (GeoMagnetic Disturbance) procedure is implemented when? - correct
answers10A or greater is measured by special equipment at Missouri Ave or
Meadowbrook and the measurement is confirmed by one of the following
other sources: Excess transformer current @ Meadowbrook, Beddington,
Donbs, or Black Oak, high MVAR requirements on transformers @ Hopw
Creek or Salem nuclear subs, or high DC measurements @ Limerick or Peach
Bottom.
What are the 2 types of National Terrorism Advisory Alerts? - correct
answersElevated and Imminent.
What action does PJM take for a terrorist attack, fuel delivery emergency, or
GMD's? - correct answersConservative Operations
What does PJM put the most emphasis on during a terrorist/sabotage event? -
correct answersOperations and Communications
pf3
pf4
pf5

Partial preview of the text

Download PJM Generation Dispatcher Exam Practice Questions and more Exams Nursing in PDF only on Docsity!

PJM Generation Dispatcher Exam Practice

exam with correct answers

An EXCITER on a traditional generator does what? - correct answersVoltage regulation (AVR) if you change the excitation current, you change the voltage. ECO Min, ECO Max, and EMERG Max are genrator _________________. - correct answersLimits When synchronizing to the interconnection, what needs to be synchronized? - correct answersFrequency, Voltage, and phase angle. GMD (GeoMagnetic Disturbance) procedure is implemented when? - correct answers10A or greater is measured by special equipment at Missouri Ave or Meadowbrook and the measurement is confirmed by one of the following other sources: Excess transformer current @ Meadowbrook, Beddington, Donbs, or Black Oak, high MVAR requirements on transformers @ Hopw Creek or Salem nuclear subs, or high DC measurements @ Limerick or Peach Bottom. What are the 2 types of National Terrorism Advisory Alerts? - correct answersElevated and Imminent. What action does PJM take for a terrorist attack, fuel delivery emergency, or GMD's? - correct answersConservative Operations What does PJM put the most emphasis on during a terrorist/sabotage event? - correct answersOperations and Communications

What does PJM request during a low voltage alert? - correct answersRRC - reactive reserve check PJM issues a Heavy Load Voltage Warning how many hours prior to implementation? - correct answers4 hours What should generation owners/operators do during a High System Voltage Action? - correct answersOperate at the lower bandwidth of the voltage schedule. How many hours do you have to report a 24-hr reportable NERC disturbance?

  • correct answers6 hours What report is generated during a Max Emergency Gen Alert? - correct answersSSR - Supplementary Status Report What part of the SSR is the Fuel Limited Resources accounted for? - correct answersPart G Resource Limited Units which are units that are not able to run at max capacity for more than 72 hours. What kind of Emergency Procedures occur during real time operating hours?
  • correct answersActions What is the per Unit (p.u.) for a 345 kV nominal voltage that is currently at 348 kV? - correct answers348/345 = 1.008 pu What is the Emergency Reducible Generation (ERG) if the Eco Min is 100 and the Emergency Min is 75? - correct answersEco Min - Emerg Min = 25MW How many Black Start units are required for critical load/TO zone? - correct answers2 Black Start units

How often is generator reactive capability testing required? - correct answersEvery 5 yrs. How much notification is required to bring a self-scheduled unit online? - correct answers20 min What time of the day does the DA- Day ahead market close? - correct answers1200 EST and all bids must be in by this time. Eco Min, Eco Max, and Emerg max are all generator ______________. - correct answersLimits What time is the rebidding period for the DA market? - correct answers4 - 6 pm Who specifies the voltage/reactive power schedule? - correct answersTO - transmission owner PJM requires generators that are greater than what level to follow a voltage schedule? - correct answers20 MVA or aggregated 75 MVA PJM sends what signals to Market Operation Centers? - correct answersACE, Regulation, and Dispatch PJM instructs your Generator to come online. From what time to the time it is running? - correct answersNotification time + Time to start

Operating reserves consists of what? - correct answersSynchronized reserves, non-synchronized reserves (quick start), and supplemental reserves (secondary) Regulating units (demand response resources) provide a variable amount of generation under automatic control to provide what? - correct answersCorrection for small deviations in load. Where's the ideal point for regulation to operate? - correct answersMidpoint What type of outage may be deferred to beyond the next weekend or can be postponed to the following Mon morning at 0800? - correct answersMaintenance outage How long is a maintenance outage during PPM- Peak Period Maintenance? - correct answers9 days How long is a maintenance outage during non-Peak Period Maintenance? - correct answersUnlimited When ambient temperatures are low, what happens to CT operation? - correct answersMW increased as temperature decreases. What is the maximum amount of reactive power increments put onto the grid during a reactive power capability test at one time? - correct answers MVAR Who can authorize a voltage schedule change? - correct answersTO - Transmission Owner

What permits the manual closing of a circuit breaker between 2 control areas? - correct answersSynchroscope What is the normal frequency control mode used by PJM? - correct answersTie-line bias A unit running for transmission congestion is subject to what? - correct answersPrice cost capping What kind of transformers are used to measure power line voltages? - correct answersPotential Transformers What is the lowest voltage in the BES? - correct answers100 kV What is the lowest operating voltage in PJM? - correct answers115 kV What side of the transformer is connected to the power source? - correct answersPrimary winding If a generator is under excited, (-) value, absorbing VAR's is it leading or lagging? - correct answersLeading PJM calls and instructs you to increase MVAR output for voltage support by 50 MVAR. What do you do? - correct answersLook at "D" curve and decrease your MW output to a level that will increase reactive power output by 50 MVAR. Planned outages are submitted no later than? - correct answers30 days
